80m² Insulated Flat Roof Reconstruction with Fleece-Backed EPDM – Bletchley
A Quality Construction project in Bletchley, Milton Keynes: 80m² Insulated Flat Roof Reconstruction with Fleece-Backed EPDM – Bletchley. The roof was fully reconstructed rather than simply overlaid, including structural repair, thermal upgrade and a premium waterproof membrane finish.
Background
Starting point
The customer wanted a reliable, properly finished solution at the property in Bletchley, Milton Keynes. The starting point was approximately 80 m² flat roof failing extensively, with large holes, overgrowth, failing fascia and damaged joists beneath the existing mineral felt. The priority was to correct the issue properly and leave a durable, professional finish.
Existing condition
Approximately 80 m² flat roof failing extensively, with large holes, overgrowth, failing fascia and damaged joists beneath the existing mineral felt. The existing construction and surrounding details were assessed so the scope could focus on the areas genuinely requiring attention.
Challenges
The main consideration was integrating the new work correctly with the existing property while maintaining weathering, finish and build quality. No unusual additional challenge is recorded for this historic project.
Photography

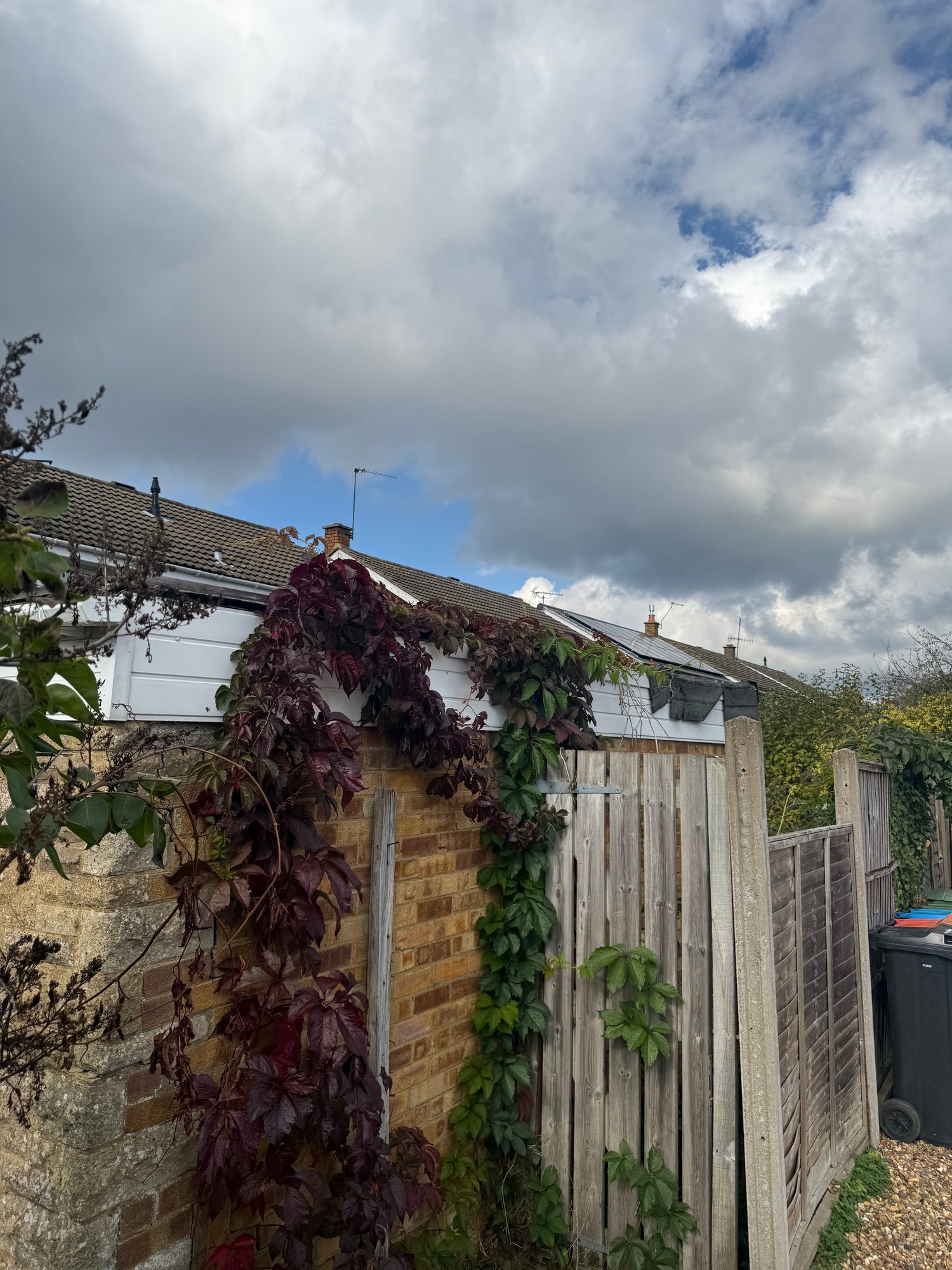

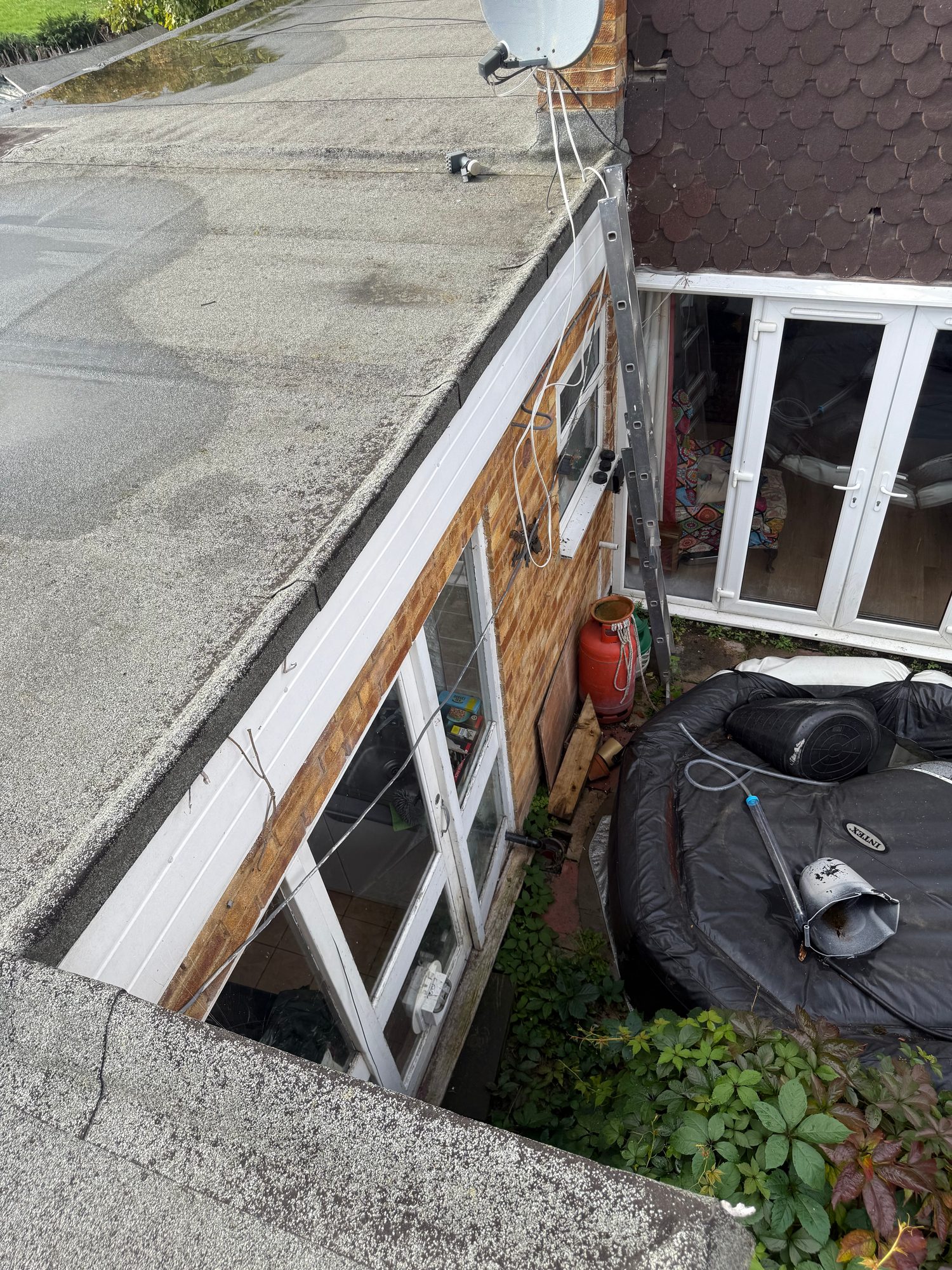

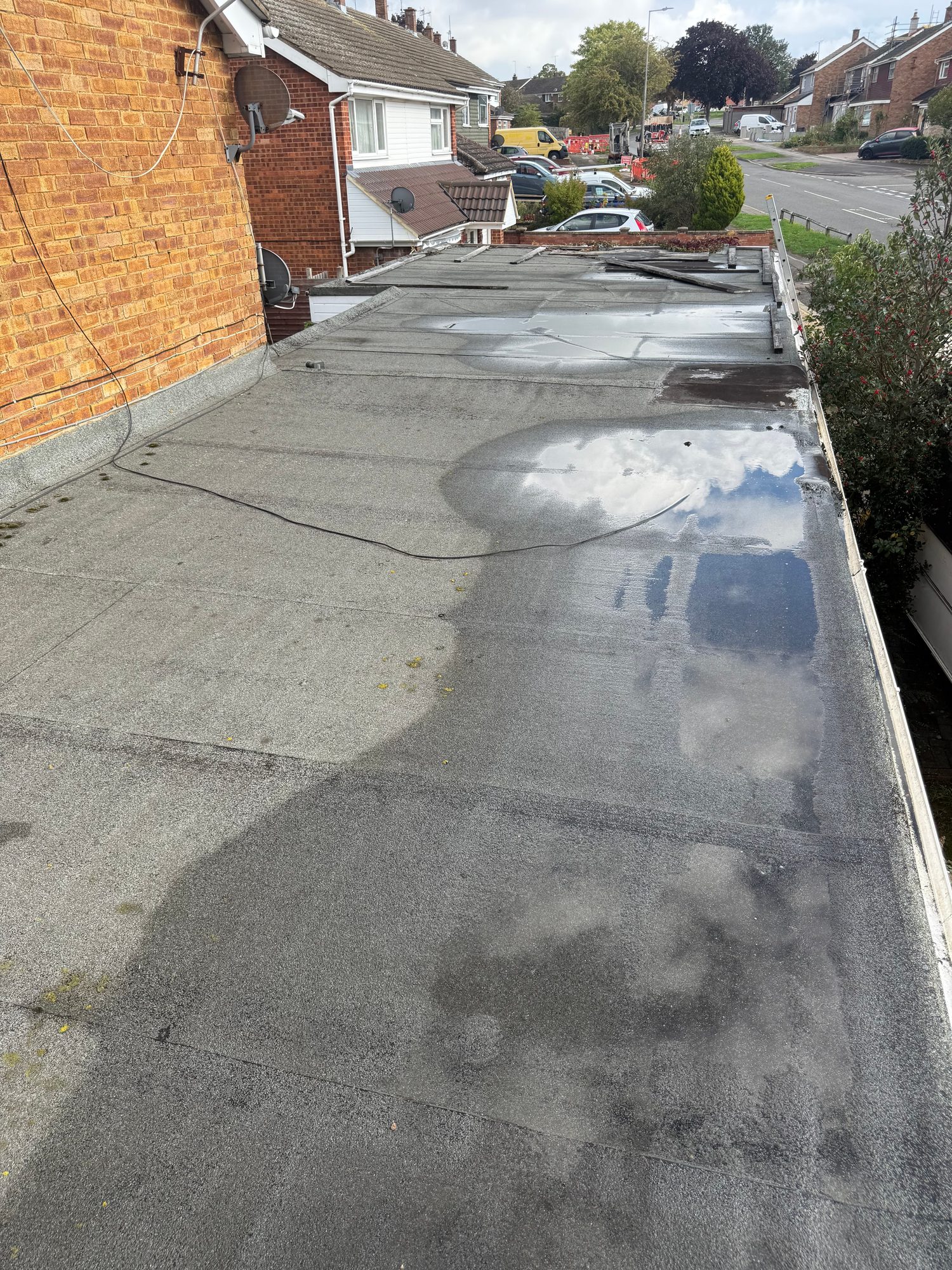

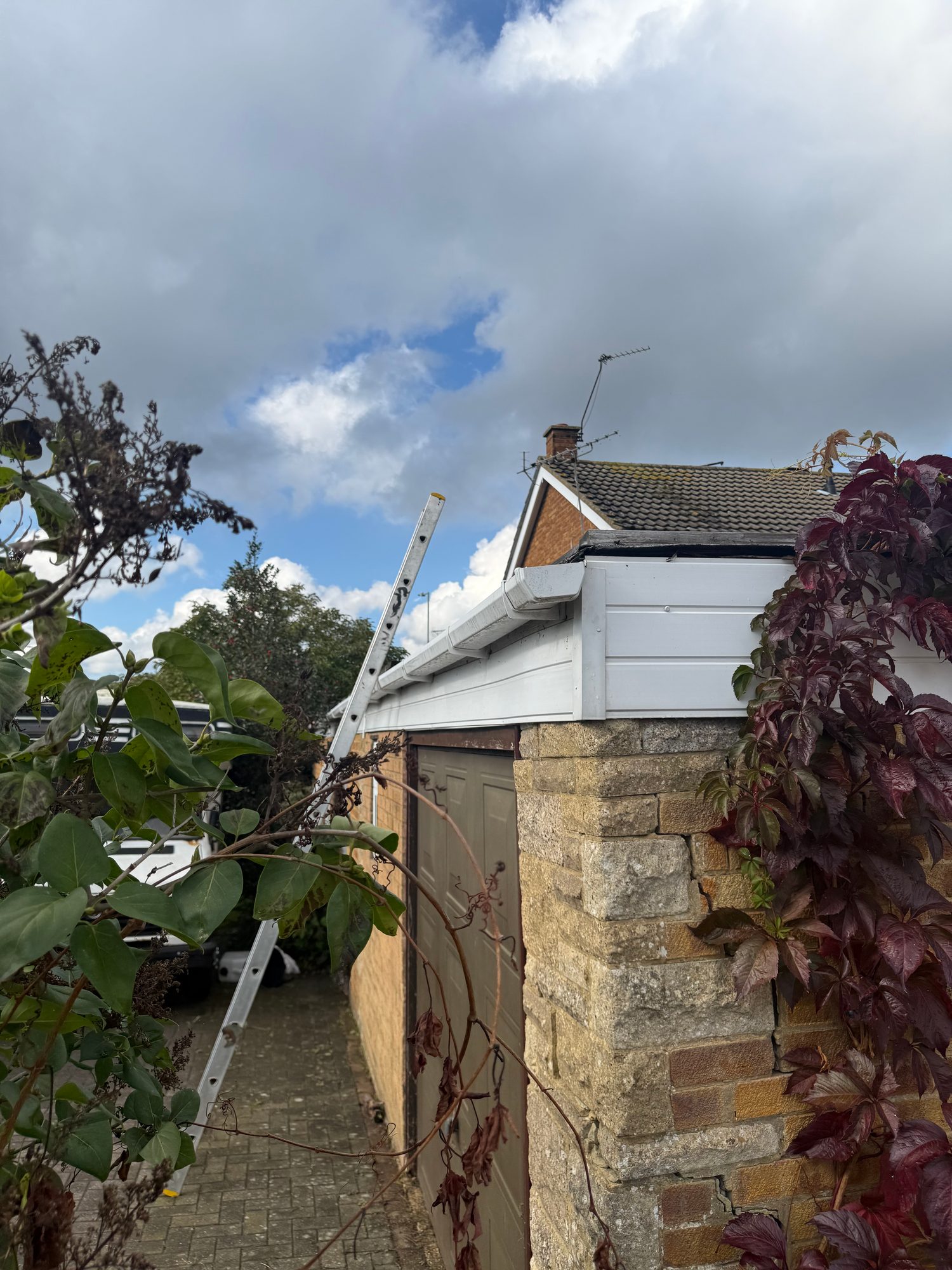

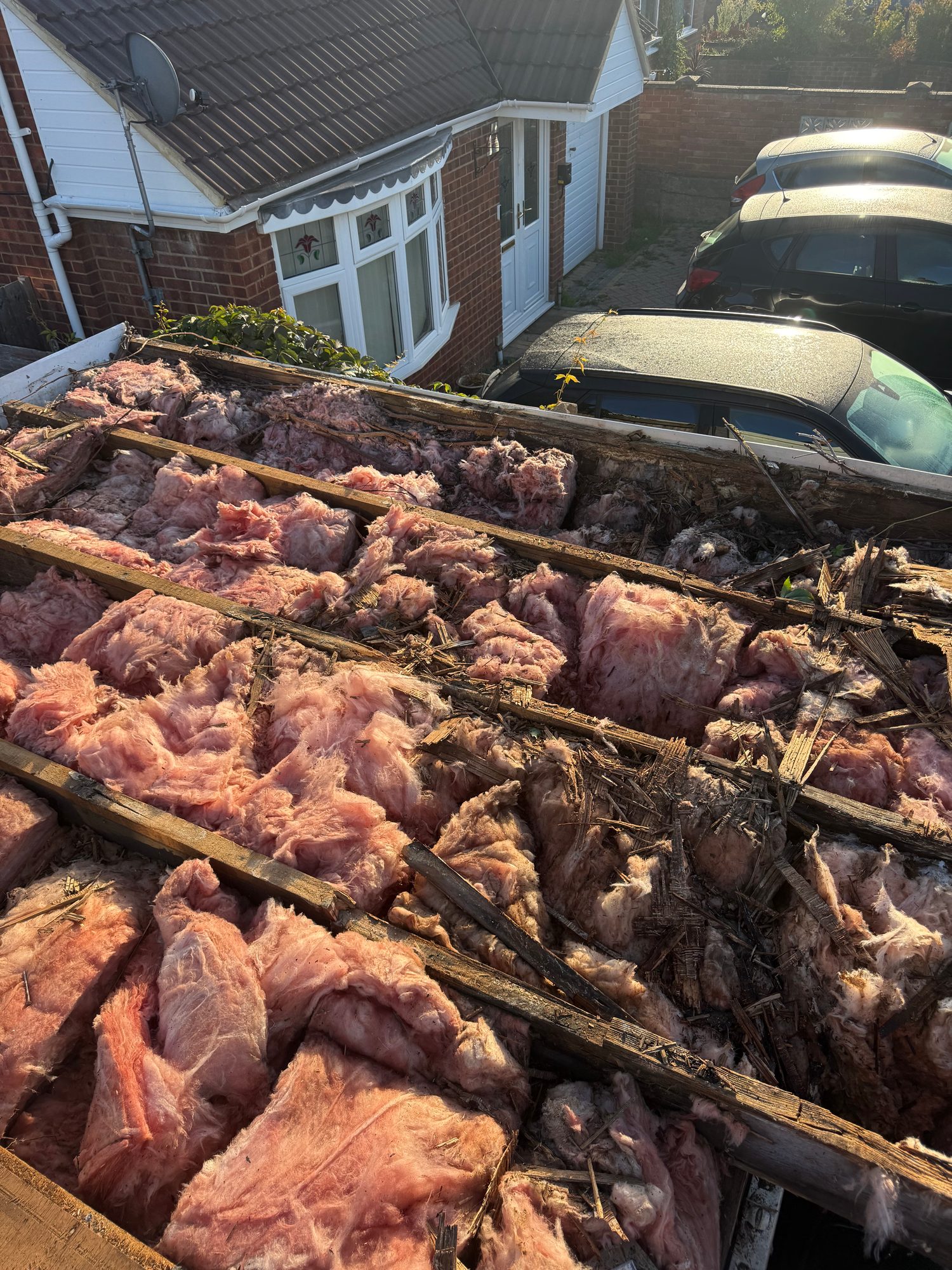

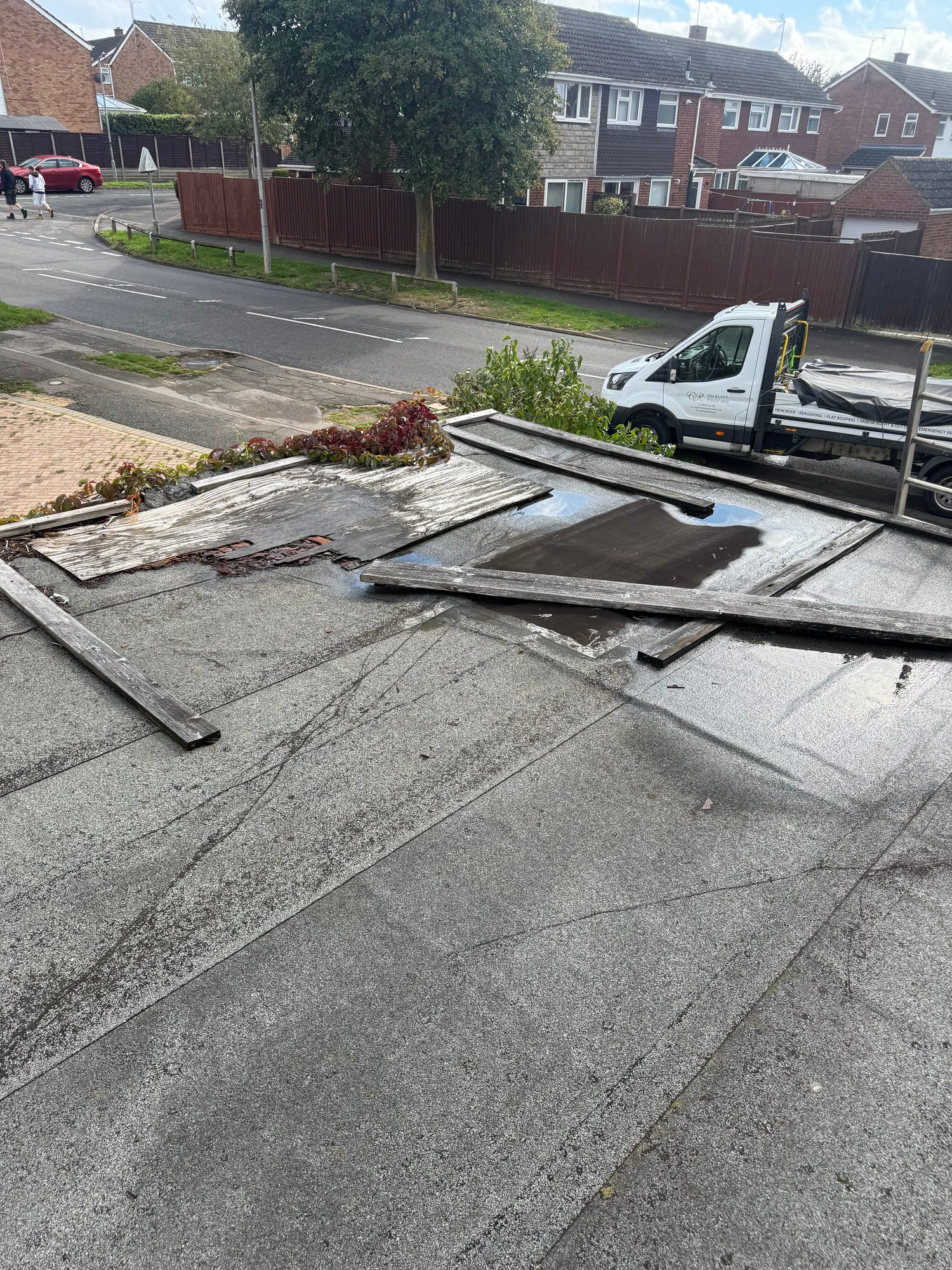

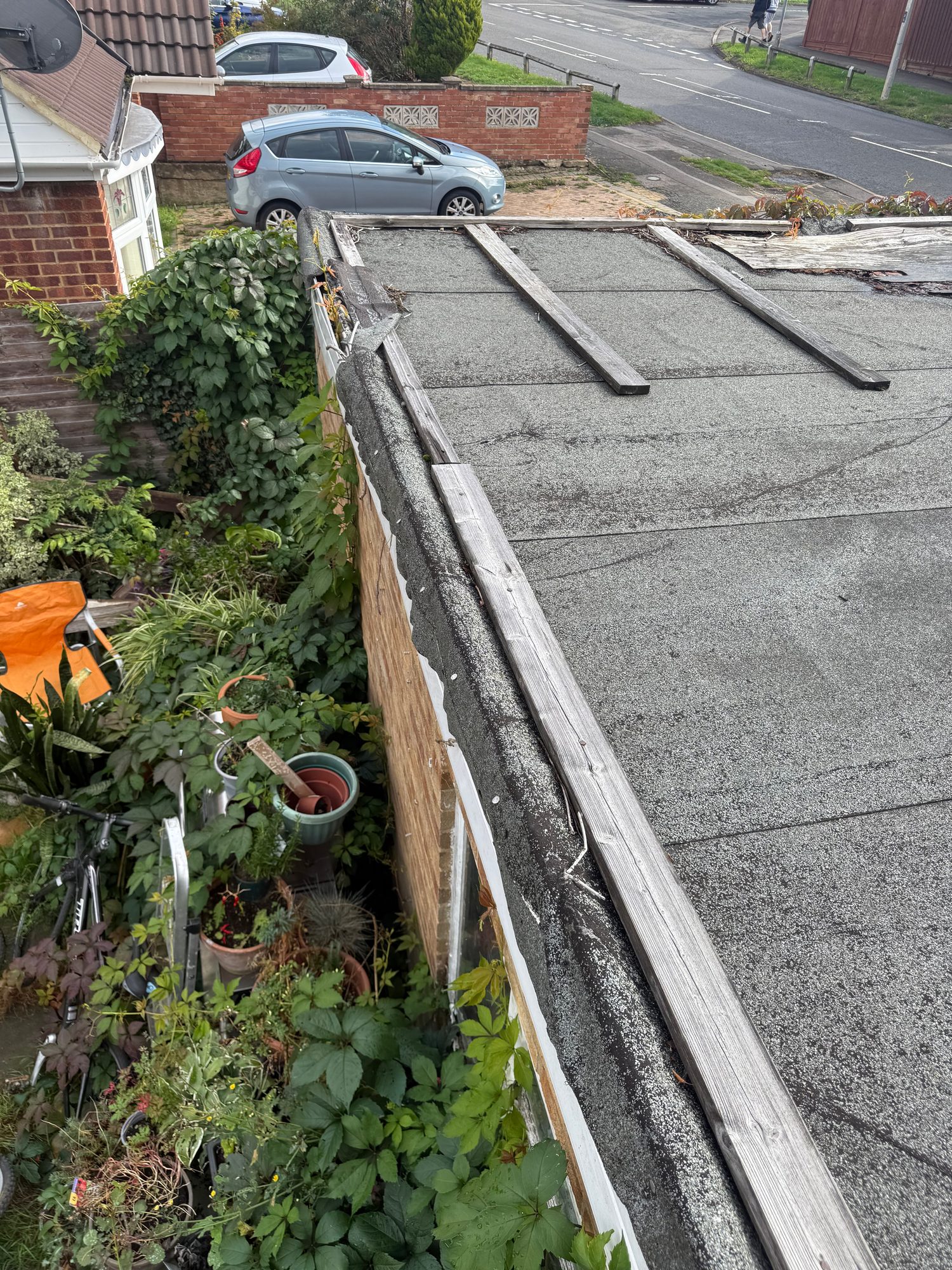

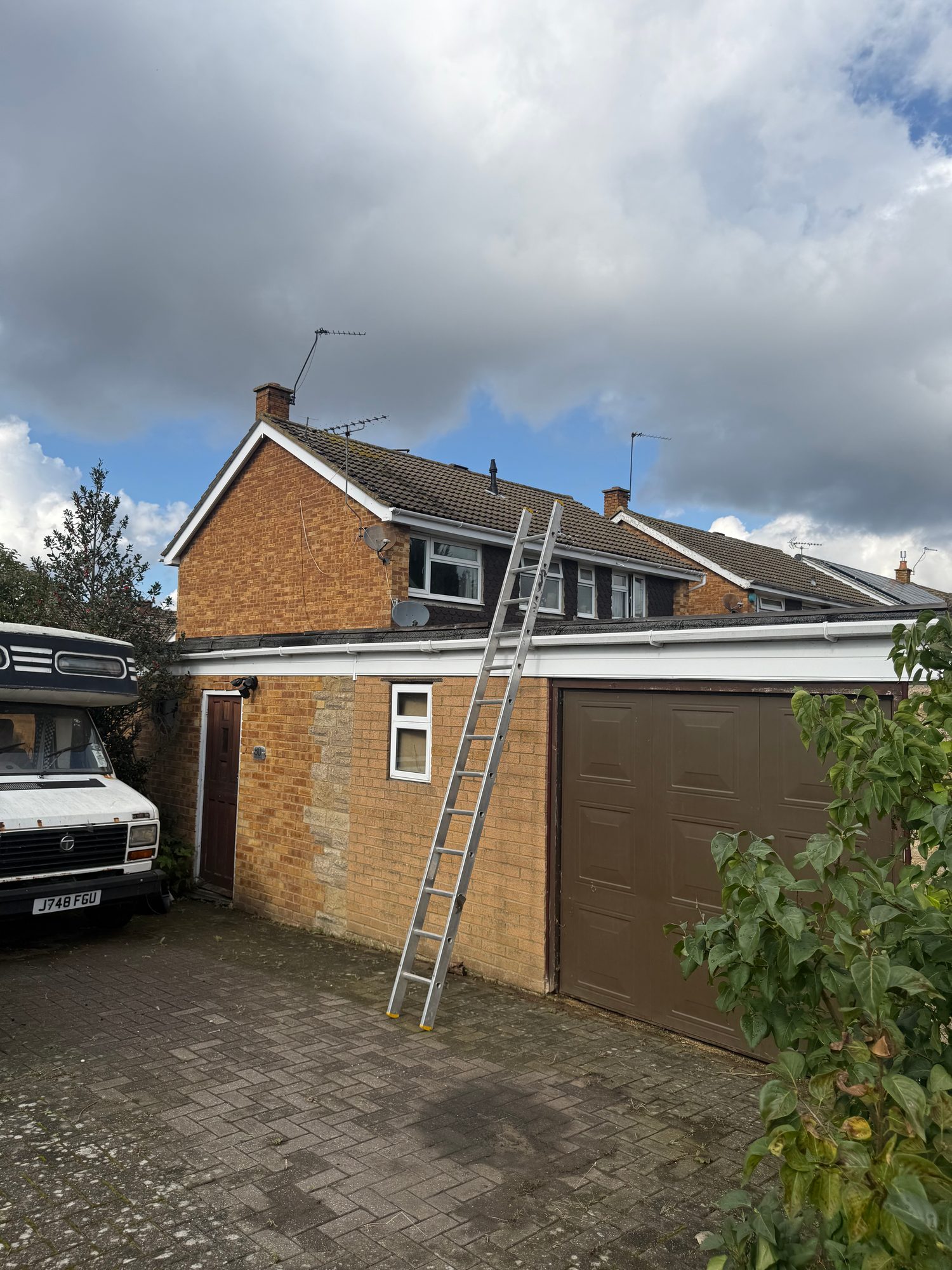

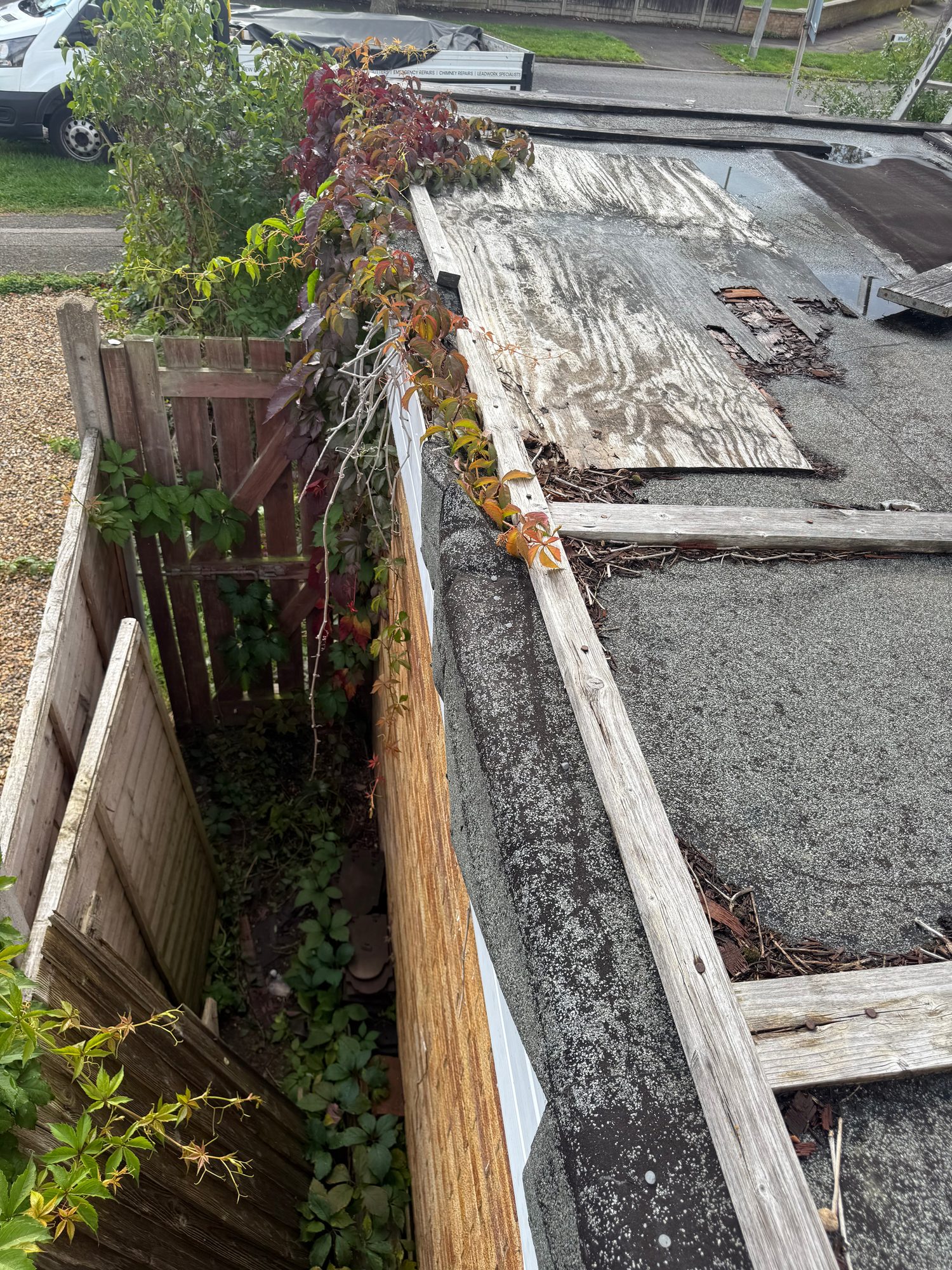

Before

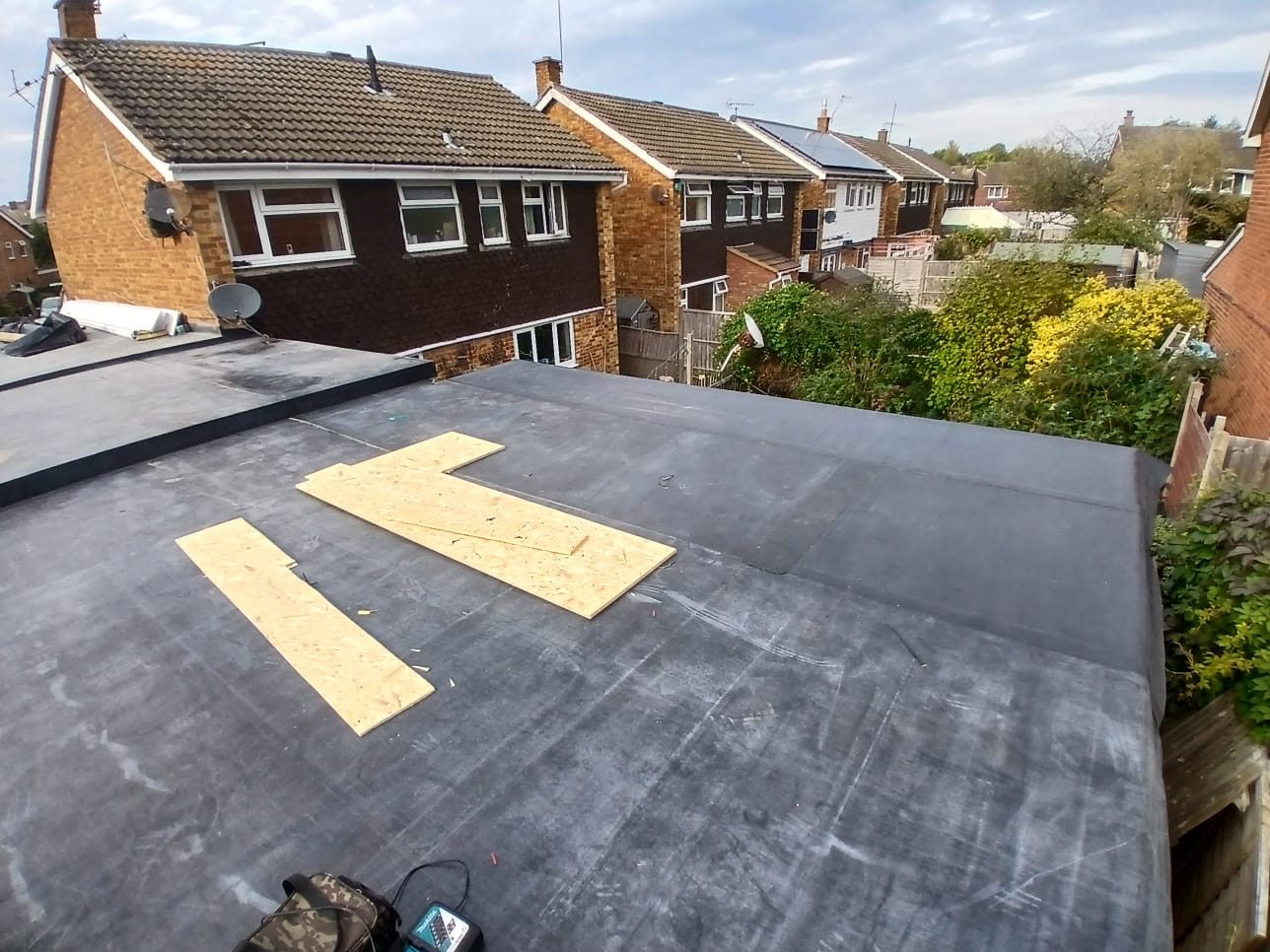

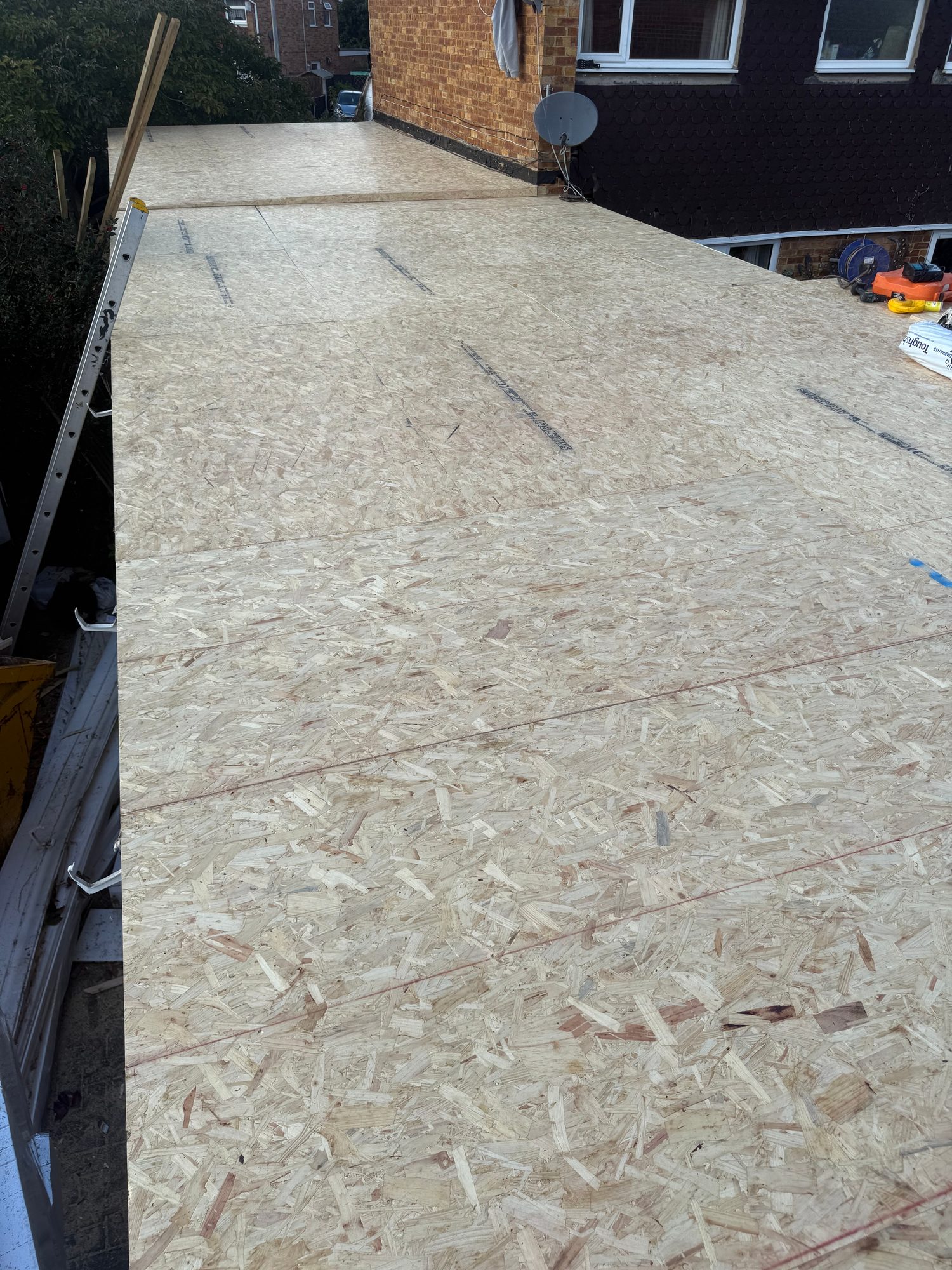

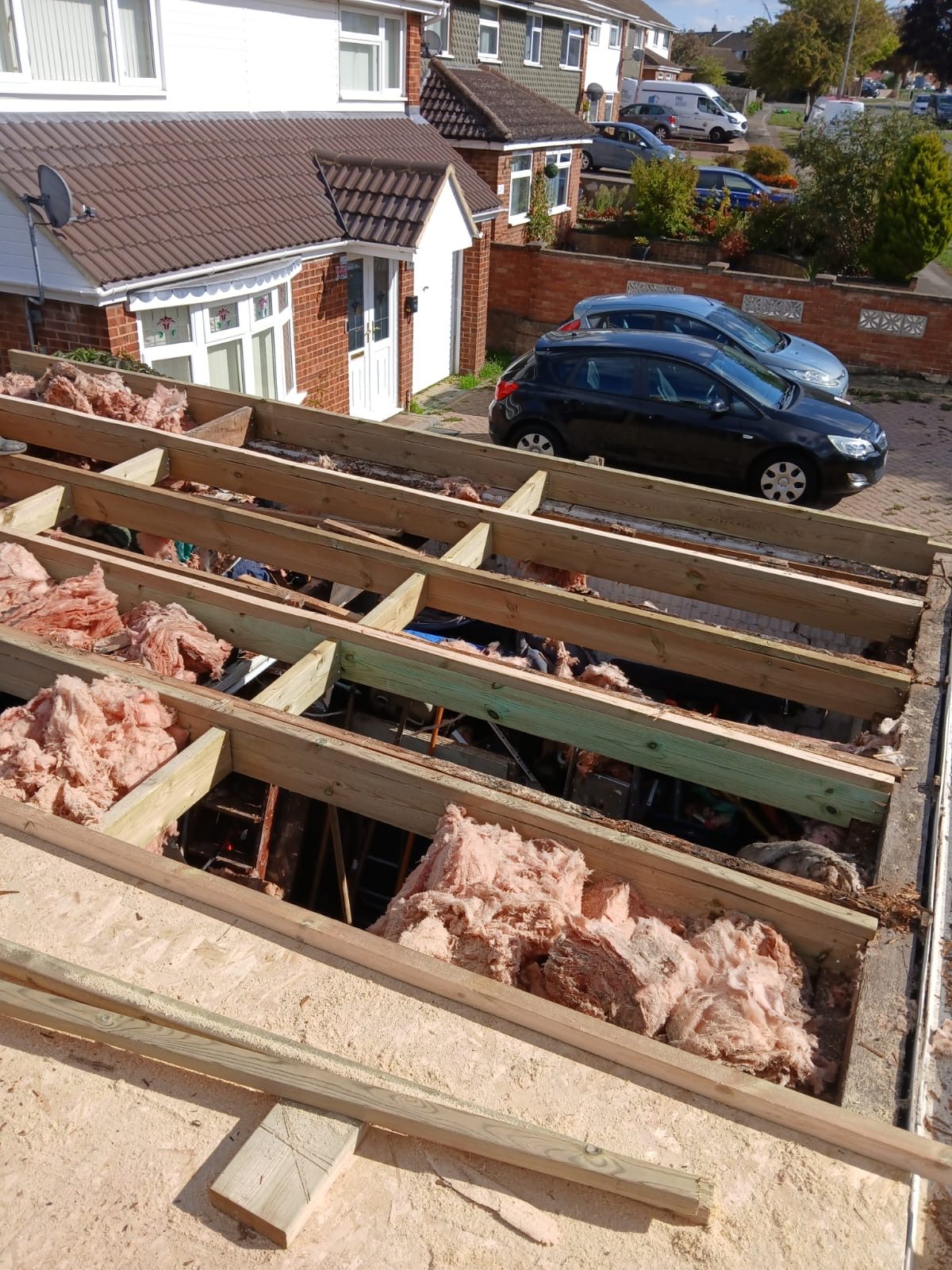

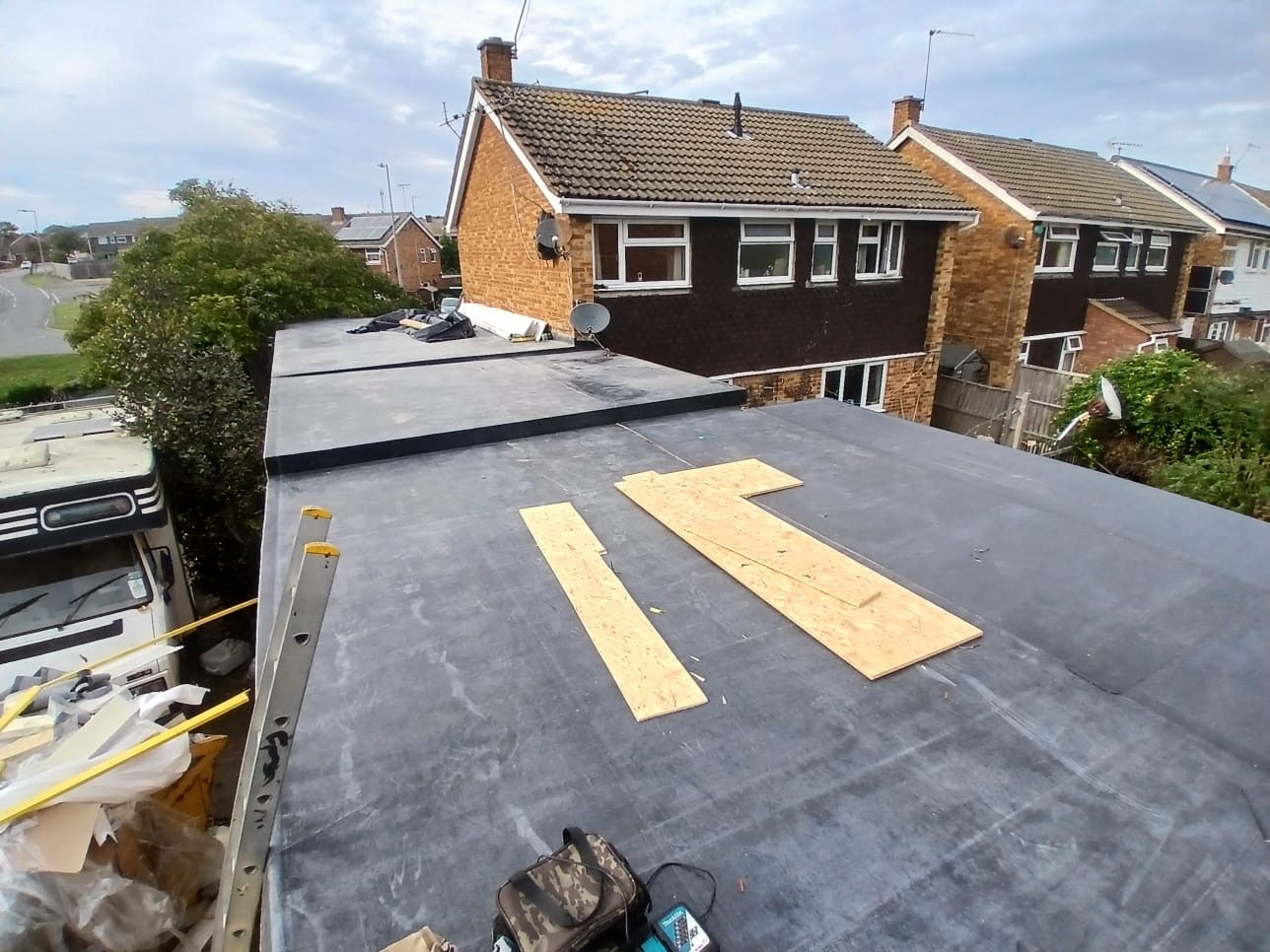

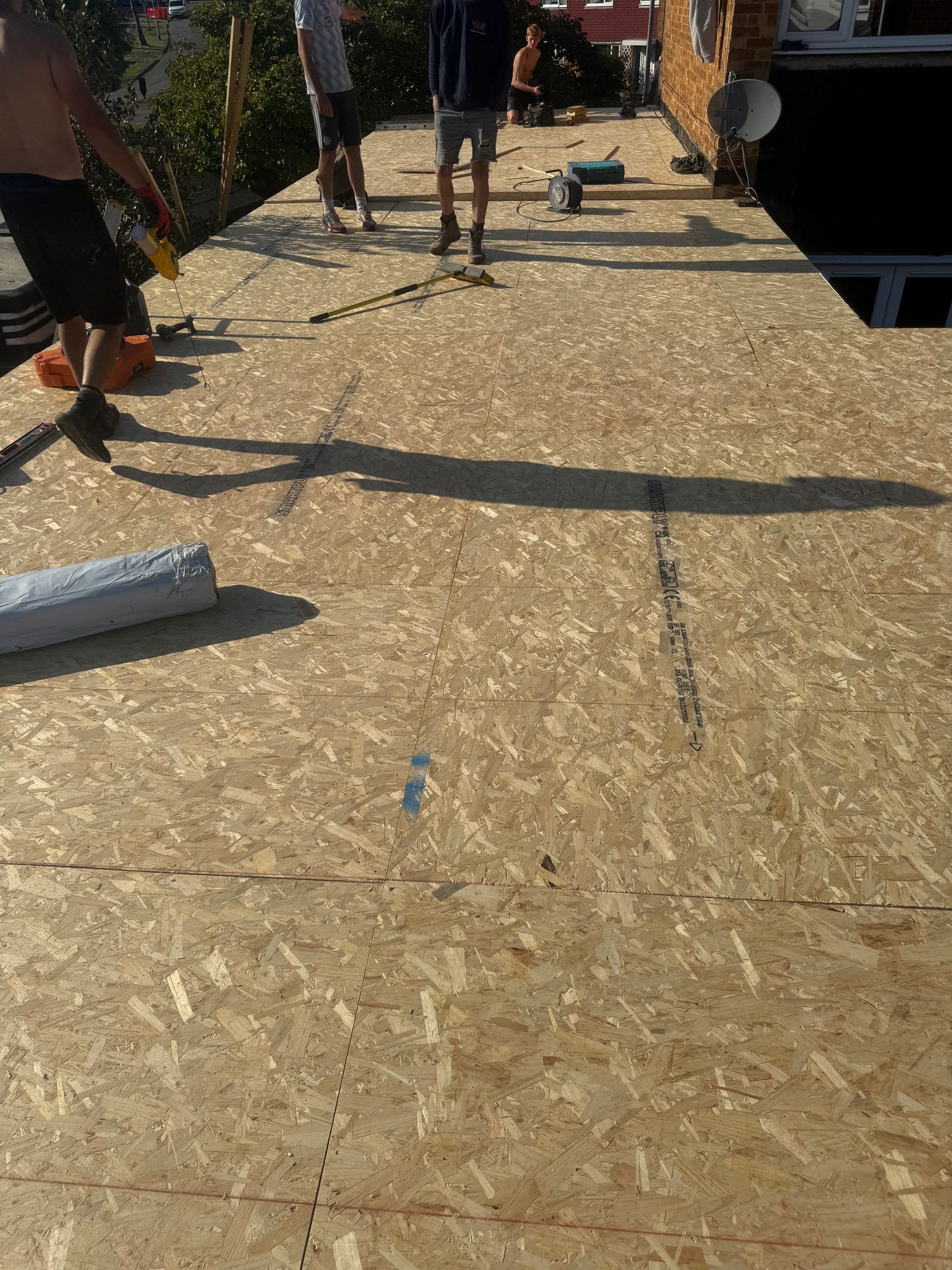

During

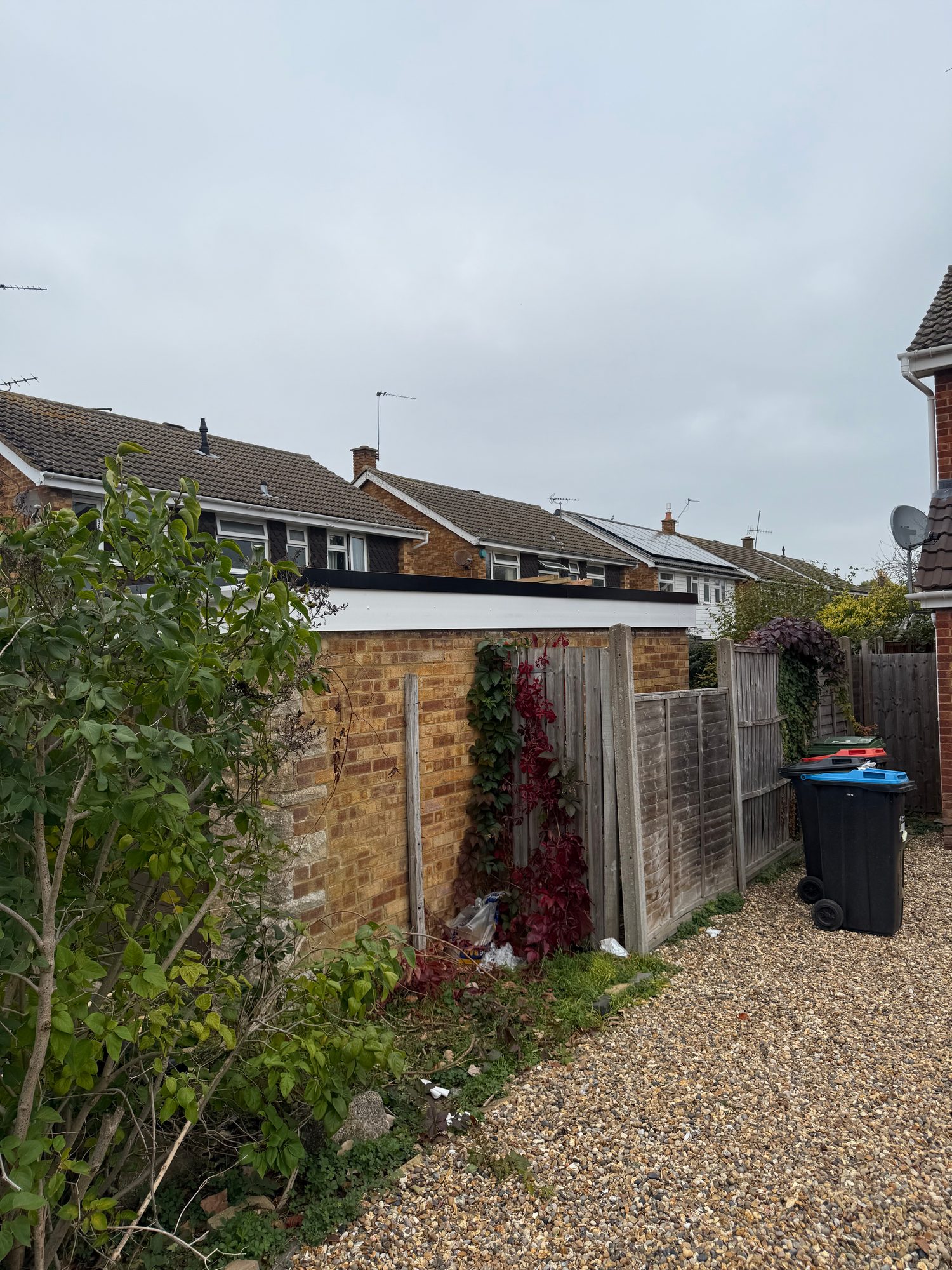

Completed
Delivery
What we did
- Stripped the roof; replaced damaged joists; installed a new 18 mm timber deck; built an insulated roof system over a DPM with timber upstands; used specialist fixings that allow movement and reduce thermal bridging; installed fleece-backed EPDM; fitted new white PVC fascias and black PVC trims.
Programme
Work stages

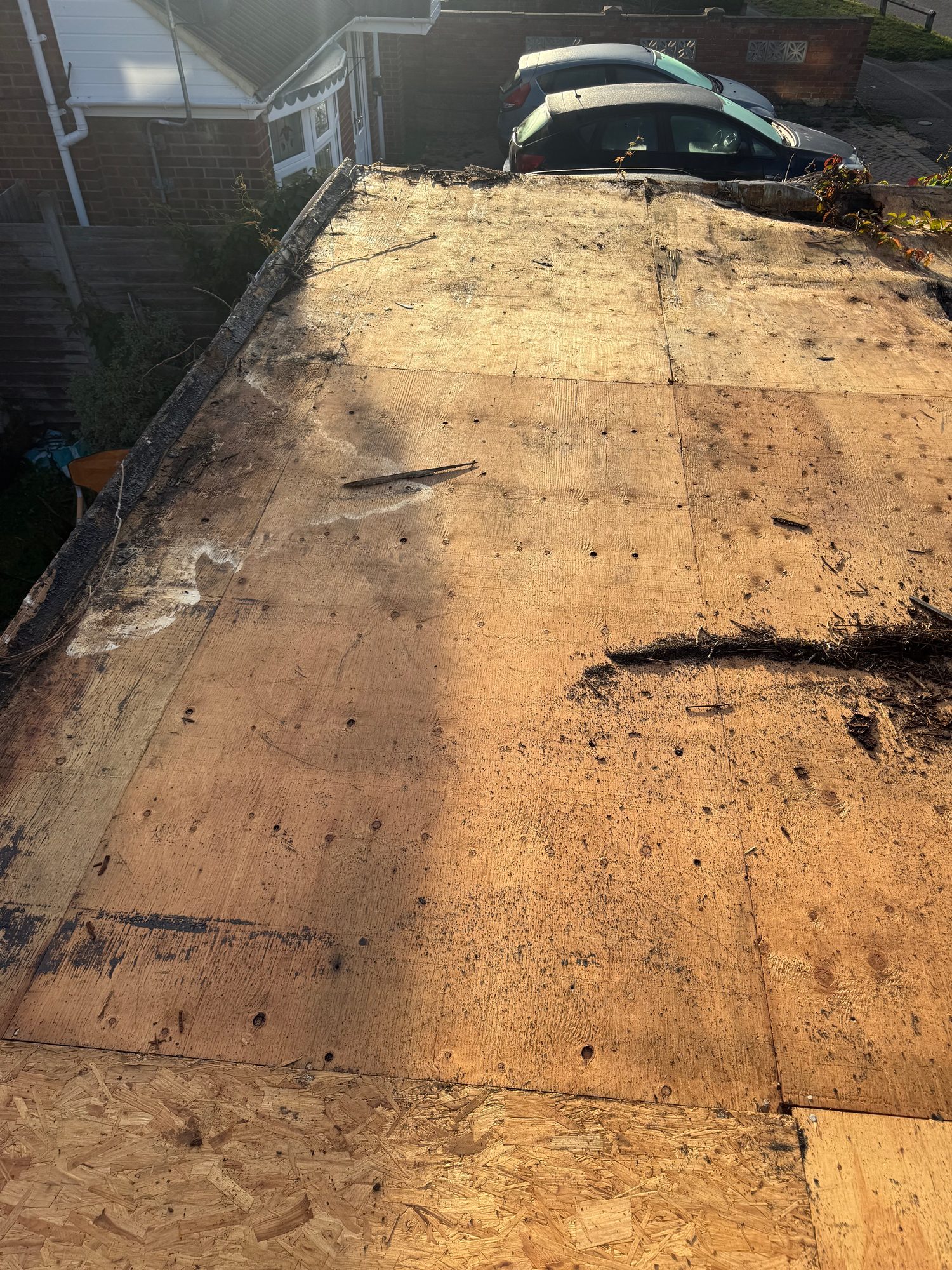

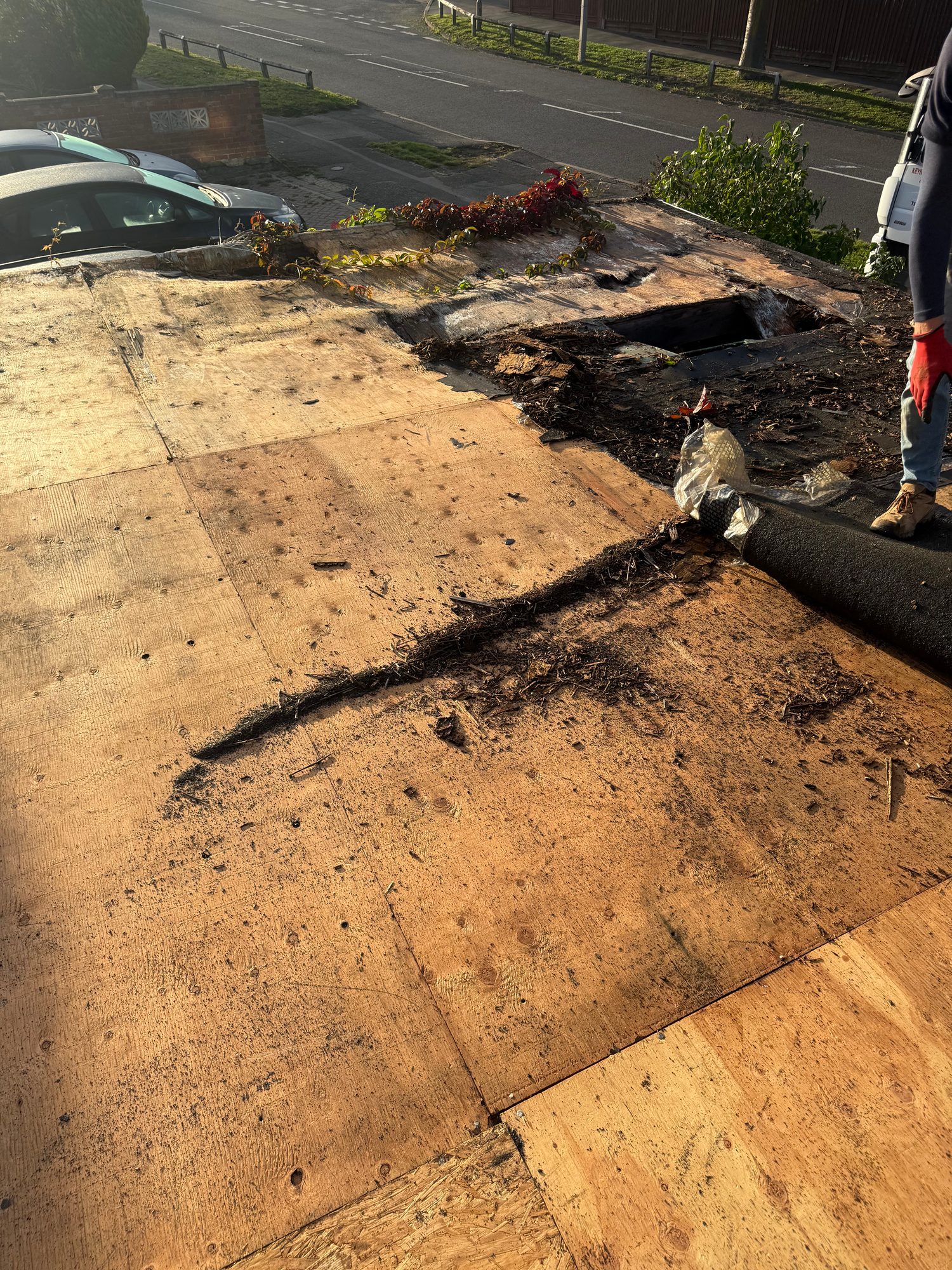

Inspection & preparation
Assess the existing substrate or prepared deck, remove failed material where required and clean the area thoroughly. QC focus: preparation, correct sequencing and quality of the inspection & preparation stage.

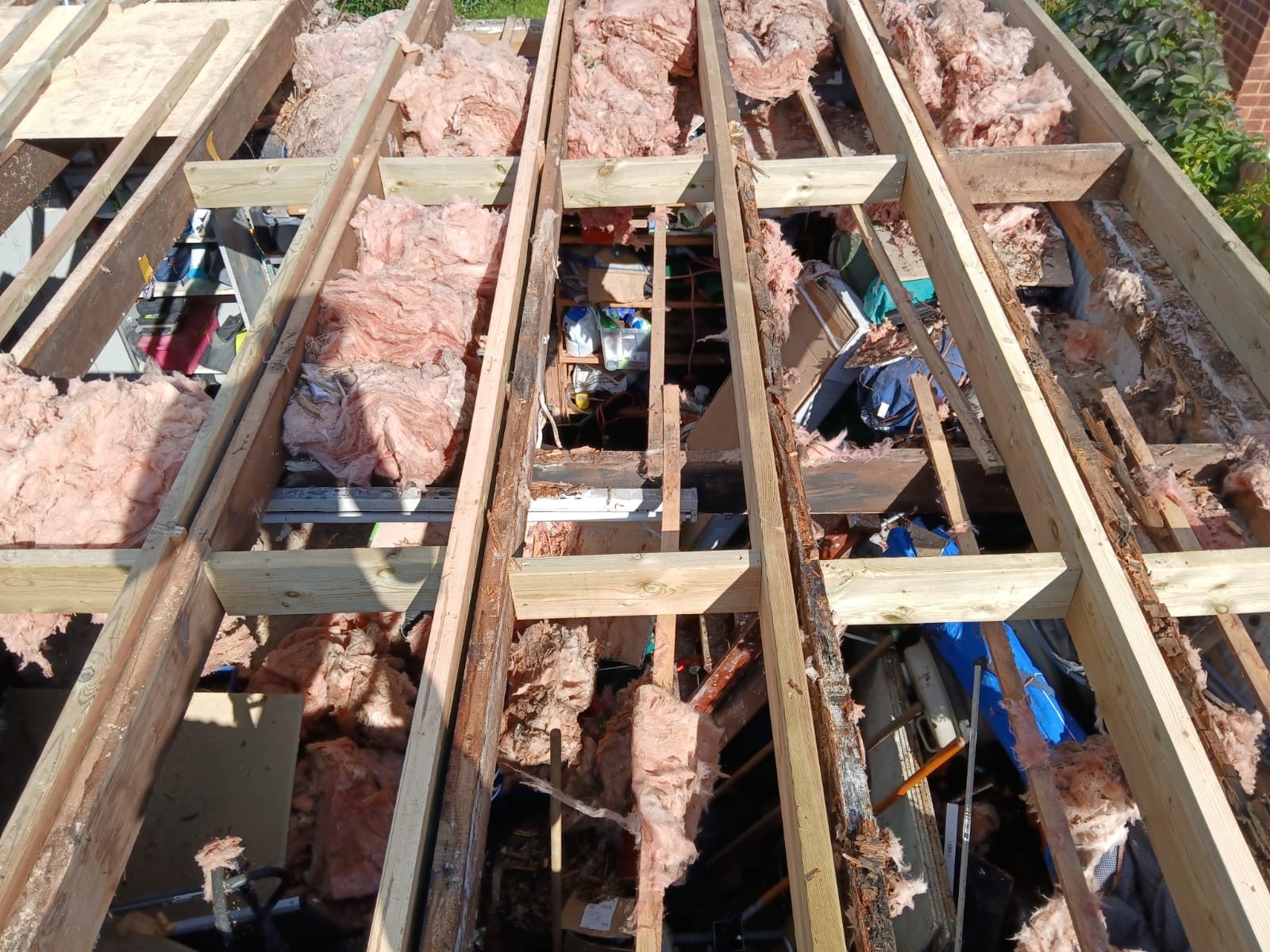

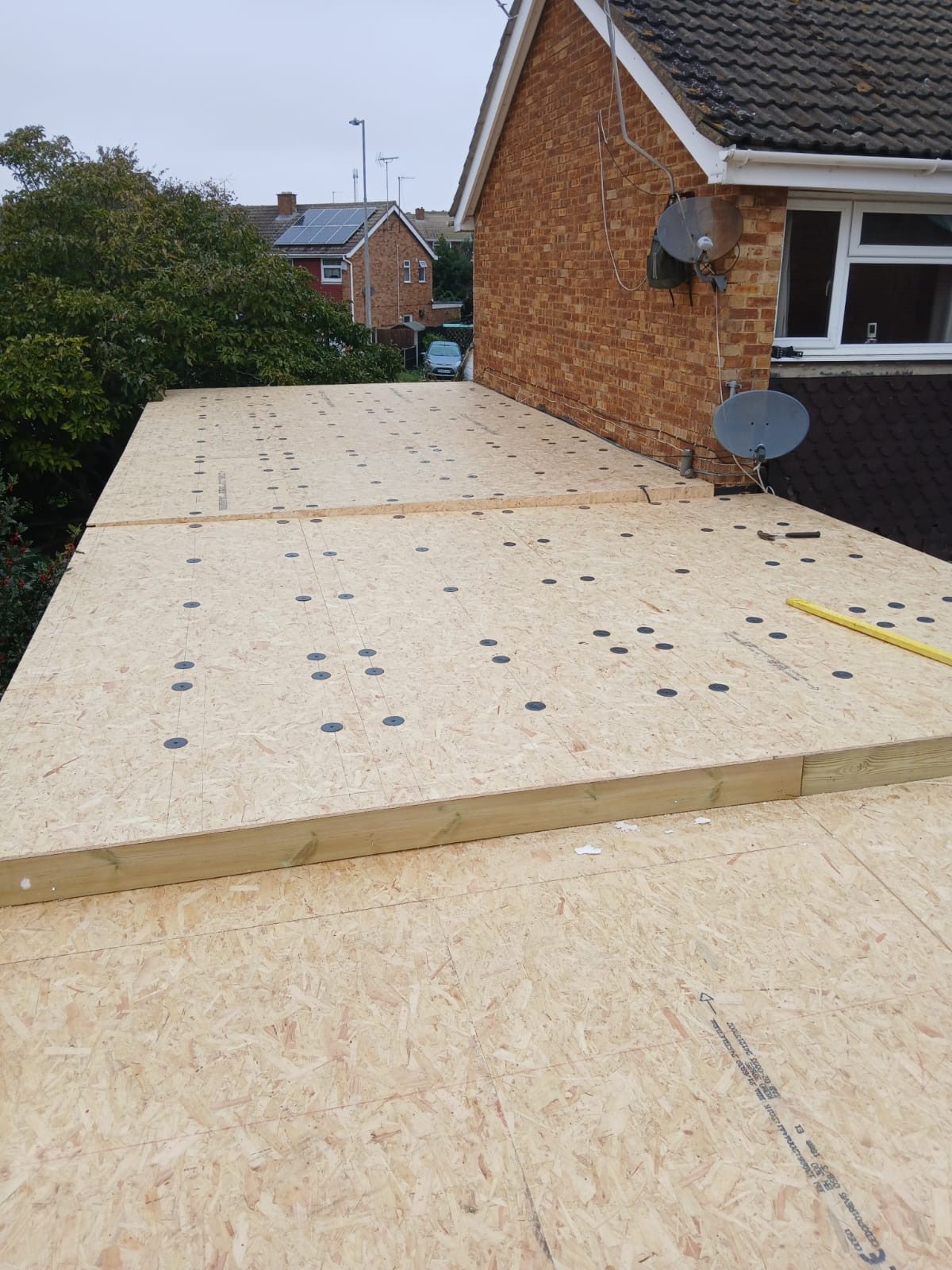

Repairs / build-up
Complete any structural, deck, DPM, insulation or upstand work required before waterproofing. QC focus: preparation, correct sequencing and quality of the repairs / build-up stage.
Waterproofing installation
Install the specified EPDM, single-ply or liquid-applied waterproofing system with careful detailing around edges, outlets and penetrations. QC focus: preparation, correct sequencing and quality of the waterproofing installation stage.
Trims & interfaces
Complete perimeter trims, wall details, fascias, gutters or adjoining roof interfaces. QC focus: preparation, correct sequencing and quality of the trims & interfaces stage.
Final inspection
Check continuity, laps/details and the finished appearance, then photograph and leave the area clean. QC focus: preparation, correct sequencing and quality of the final inspection stage.
Specification
Products & materials
Fleece-backed EPDM membrane
- Specification
- Premium fleece-backed rubber membrane
Selected for durable flat-roof waterproofing and a robust bonded finish.
On site
Problems solved
Issue
The main consideration was integrating the new work correctly with the existing property while maintaining weathering, finish and build quality. No unusual additional challenge is recorded for this historic project.
How we fixed it
Quality Construction recommended a targeted, properly prepared installation rather than a temporary cosmetic repair. The agreed approach was to stripped the roof; replaced damaged joists; installed a new 18 mm timber deck; built an insulated roof system over a DPM with timber upstands; used specialist fixings that allow movement and reduce thermal bridging; installed fleece-backed EPDM; fitted new white PVC fascias and black PVC trims. with attention to preparation, detailing and long-term performance.
Outcome
The roof was fully reconstructed rather than simply overlaid, including structural repair, thermal upgrade and a premium waterproof membrane finish.
Standards
Planning, quality & handover
Quality control
Quality checks focused on preparation, alignment, weathering/detailing, fixings and the finished appearance relevant to this 80m² insulated flat roof reconstruction with fleece-backed epdm – bletchley. Photographs should be used to evidence visible and hidden-stage workmanship where available.
Project management
The works were organised around a planned sequence and completed over 5 days. Materials, access and individual work stages were coordinated so the project could progress efficiently with minimal unnecessary disruption.
Outcome
The result
The roof was fully reconstructed rather than simply overlaid, including structural repair, thermal upgrade and a premium waterproof membrane finish.
